Little Hulton investment

£1.2m Little Hulton investment

We're delivering the largest ever investment in the North West’s power network, investing over £1bn between 2023 and 2028.

We're committed to maintaining and improving the network through our capital investment programme

This £1.2m capital project investment will significantly enhance the resilience and capacity of the power network in Little Hulton, Salford, Bolton and the surrounding areas. Hundreds of homes and businesses will benefit from the new electricity supply which will future-proof the network to enable local residents and businesses to connect to low carbon technologies such as EV chargers, heat pumps and solar panels.

This project sees the installation of high-voltage underground power cable along a 4km route as well as new equipment installed in our substations.

🔔 Traffic management information

We always aim to carry out our work as planned and with as little disruption as possible. However, the dates we publish for road works can sometimes change. This is because a number of factors outside our control can affect when it is safe or practical for our teams to work, such as weather conditions, ground conditions and emergency repairs.

March 2026 - August 2026

Start date

End date

Traffic management

01/04/2026

08/04/2026

Road closure - Peel Park Crescent

06/04/2026

12/04/2026

3 Way Signals - Stocksfield Drive

13/04/2026

19/04/2026

3 Way Signals - Junction of Kenyon Way & Road Closure of Stocksfield Drive

20/04/2026

26/04/2026

3 Way Signals - Junction with Highfield Road

27/04/2026

03/05/2026

3 Way Signals - Junction with Hazel Avenue

05/05/2026

10/05/2026

2 Way Signals & Road Closure - Oakfield Drive

11/05/2026

17/05/2026

3 Way Signals - Junction with Lester Road & Road Closure of Green Avenue

18/05/2026

24/05/2026

3 Way Signals - Junction with Rothwell Crescent – Access to Wharton Lane Maintained

18/05/2026

26/07/2026

3 Way Signals - Salford Road, Bolton

25/05/2026

31/05/2026

3 Way Signals Junction with Clarke Crescent – Access to Co-Operative Street Maintained

01/06/2026

05/06/2026

2 Way Signals - Clarke Crescent and Caddie Road

06/06/2026

14/06/2026

3 Way Signals - Junction with Caddie Road – Bolton Council Notification Required

22/06/2026

23/08/2026

3 Way Signals - Bridgewater Avenue, Bolton

06/07/2026

02/08/2026

3 Way Signals - Leadbeaters Lane, Bolton



Project overview

The work runs from March 2026 and is scheduled to be completed in August 2026.

The project supports our commitment to reinforcing the network to increase load capacity across Greater Manchester to enable future development, increase economic growth and connection to low carbon technologies as we become more and more reliant on electricity. Once complete, the project will facilitate an additional 5.4 Megavolt Amperes (MVA) to the local power network - that's enough to power over 2,000 homes.

We are working closely with Salford and Bolton Councils to coordinate works and minimise disruption.

Road closures and diversions are necessary but will be carefully planned and communicated in advance in collaboration with local authorities.

We are committed to keeping residents, businesses, and commuters informed every step of the way.

Little Hulton Frequently asked questions

Explore our FAQs

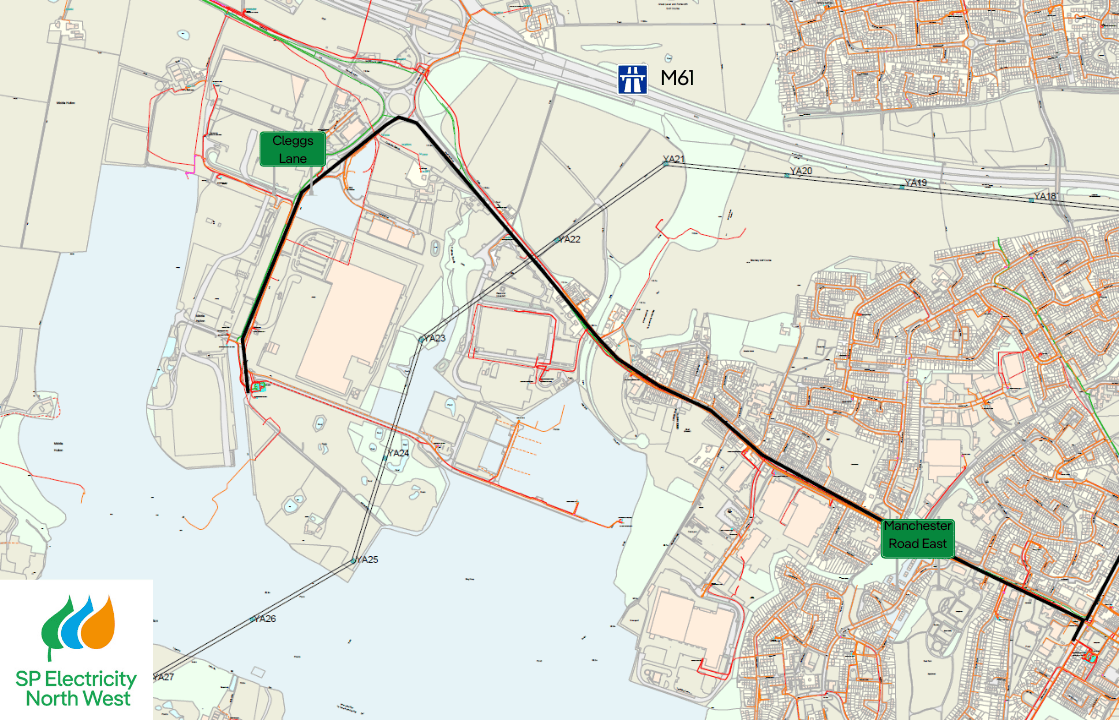

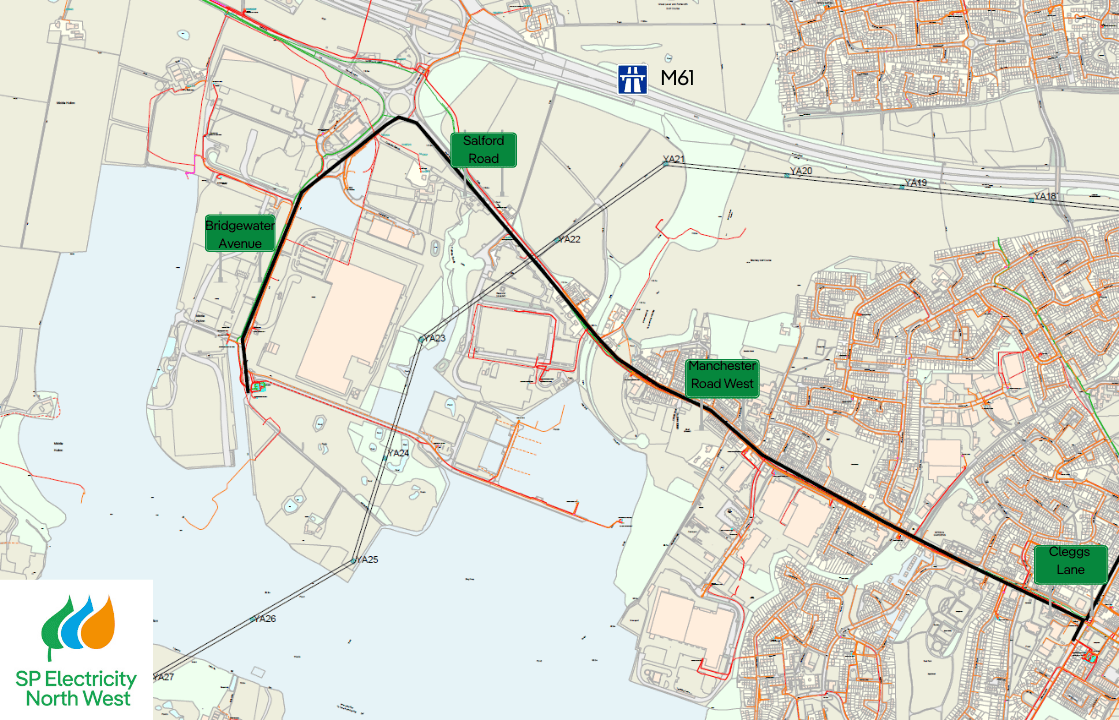

Map of route
